5 Key Tips for Choosing the Right Air Compressor for Your Business
Equipment Guide

5 Key Tips for Choosing the Right Air Compressor for Your Business

Technical Guide
18 min read

About 90% of the electricity a compressor consumes turns into heat. The remaining fraction turns into pressurized air. That conversion ratio is set by thermodynamics and no product innovation will change it. What can be changed is how much of that pressurized air gets wasted after it leaves the machine, and the answer in a typical facility is: a lot of it.

1
Match the Compressor to Your Demand Profile, Not Just Your Peak Demand

Most compressor purchases start and end with peak demand. Someone adds up the CFM requirements of all the tools in the shop, tacks on a margin, and buys a machine that covers the total. The machine arrives, gets plumbed in, and works. Everyone is satisfied.

The dissatisfaction comes later, on the electricity bill, and it is diffuse enough that the connection to the compressor is never made. That machine was sized for a moment that might occur once per shift and now it runs all shift. A body shop running two DA sanders simultaneously for 15 minutes needs 30 CFM during those 15 minutes and zero CFM for the next 45. A compressor sized to cover that 30 CFM spike sits idle three quarters of the time. "Idle" on a fixed-speed rotary screw does not mean off. The motor keeps spinning, the inlet valve throttles to minimum, the oil circulates, and the machine draws 25 to 35% of its full-load power to produce nothing. On a 50 HP unit at $0.10/kWh, that parasitic draw during unloaded operation adds up to over $3,000 per year. Nobody puts that number on the quote.

60–80%

The load factor, average consumption divided by maximum output, is what exposes oversizing. Below 50%, too big. Above 85%, too small. Between 60% and 80% is where the economics work.

Variable Speed Drive compressors slow the motor down when demand drops. Good technology. Not magic. They have a speed floor at 20 to 25% of rated RPM, below which they unload or shut off. Skeleton-crew nights and weekend trickle demand drop below that floor. A smaller fixed-speed machine for the off-hours paired with the VSD for daytime swings is a two-machine answer. Counterintuitive. Cheaper over five years.

VSD drive boards are sensitive to dirty power. Welders, plasma cutters, large motors starting direct-on-line. A replacement board runs $4,000 to $7,000. A $500 input line reactor in front of the VSD prevents this. IEEE 519 puts the harmonic distortion threshold at 5% THD at the point of common coupling. Most shop owners have never heard of IEEE 519 and do not need to. They just need the line reactor.

CFM ratings across manufacturers are measured differently. One quotes displacement CFM, another quotes free air delivery, a third corrects to standard conditions that exist in no actual building. The CAGI Performance Verification Program standardizes this through data sheets showing FAD per ISO 1217 Annex C. The sheets are free on the CAGI website.

Buy for current demand plus 15 to 20% headroom. Size the piping to support a second machine later.

Do not buy 40% oversized because a sales engineer thinks the business might grow into it. Growth is speculative. Electricity cost is not.

Where the compressor pulls intake air is a detail that gets decided during installation by whoever is doing the plumbing, and it affects performance every hour the machine runs afterward. A machine rated at 100 CFM at standard conditions delivers measurably less at 95°F ambient and 1,000 feet elevation. A compressor room in Phoenix that hits 110°F in July with the intake pulling air from a grinding bay will underperform its nameplate, load its intake filter faster, and introduce contaminants into the oil circuit. Ducting clean outside air to the intake is a construction-phase decision. Post-occupancy it costs ten times as much and usually never happens.

2
Understand the Real Cost Differences Between Compressor Types

Electricity is 76% of the ten-year cost of owning a compressor. The purchase price is 12 to 13%. This has been published by every energy agency that has looked at it. It is not in dispute. It is ignored because the electricity bill does not have a line item that says "compressor."

Above 6 hours loaded per day: buy a rotary screw. Below 4 hours: buy a two-stage reciprocating. Between 4 and 6 depends on what electricity costs locally.

Specific power, kW per 100 CFM at a given pressure, is the number that matters. At 100 psig a good rotary screw runs 18 to 19. A two-stage recip runs 23. A contractor-grade single-stage from a big-box store runs 29 or 30. CAGI data sheets publish this.

Compressor distributors earn margin on equipment, and fatter margins live on larger machines. A distributor who sizes a 50 HP compressor when 30 HP covers the demand is not doing anything unusual. That is how equipment distribution works in every capital goods category. Independent demand data is the only counterweight. Electric utilities across the U.S. fund compressed air audits through demand-side management programs. Engineers with no equipment stake measure flow, log pressure, tag leaks, calculate demand. Free in many cases. Few small businesses know these exist, partly because the utilities market them poorly and partly because a business owner's instinct when they have a compressor question is to call the compressor dealer, and the dealer is not going to recommend that a competitor come in and potentially downsize the sale.

Maintenance is where the reciprocating versus screw conversation gets interesting in ways that do not show up on a spec sheet. Recips have valves, rings, pistons. They need attention more often. The work is mechanical, parts are cheap, any decent mechanic can handle it with hand tools. Screws have fewer wear items but the ones they have are expensive and the intervals are non-negotiable. Miss an oil change on a recip and the valves carbon up, the machine loses efficiency, the valve plate eventually needs reconditioning. That is an afternoon job and a $200 parts order. Miss an oil change on a rotary screw and the bearings start to wear, the airend heats up, and six months later the machine needs a rebuild that costs more than a new mid-range recip would have. The margin for error is wider on a recip. The cost of getting it wrong is higher on a screw.

Full-synthetic compressor oils go 8,000 hours between changes. Mineral oils go 2,000. Over a 40,000-hour airend life that is 5 oil changes versus 20. The synthetic runs the airend 10 to 15 degrees cooler and produces less varnish. The mineral oil stays popular because it is the default on the invoice and the default goes unchallenged.

Some manufacturers design filter housings that accept only proprietary elements. The buyer discovers this at the first filter change when the aftermarket supplier cannot match the part. OEM replacements carry markups of 200 to 400% over aftermarket equivalents. Ask before purchase whether the consumables are standard-size or proprietary. If the salesperson hesitates, that is an answer.

3
Treat Air Quality as a System Design Problem

Air quality failures scatter their symptoms across departments. Paint shop blames the paint. Maintenance blames the pneumatic cylinders. Assembly blames the tools. The compressed air system caused all three problems and it takes months before anyone tests the air supply.

18 gal

How much moisture a compressor produces depends on ambient conditions at the installation site. A 100 CFM compressor at 95°F intake and 90% relative humidity generates over 18 gallons of condensate in an 8-hour shift. At 50°F and 30% humidity, 3 gallons. Dryer manufacturers publish correction factors but they require the buyer to look up worst-case ambient conditions and do the multiplication. Most buyers skip this, accept the catalog standard rating, and find out in August that the dryer cannot keep up.

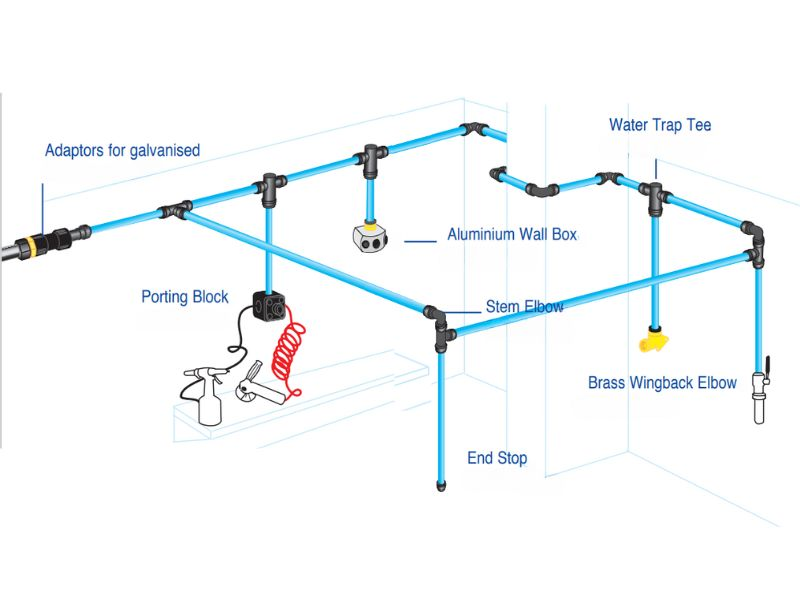

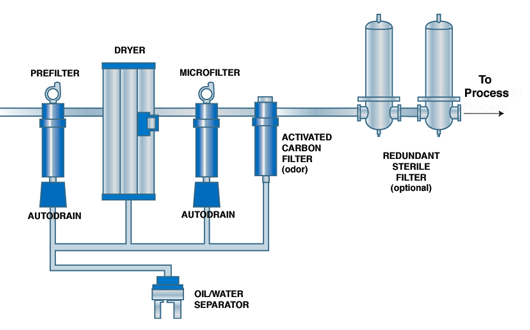

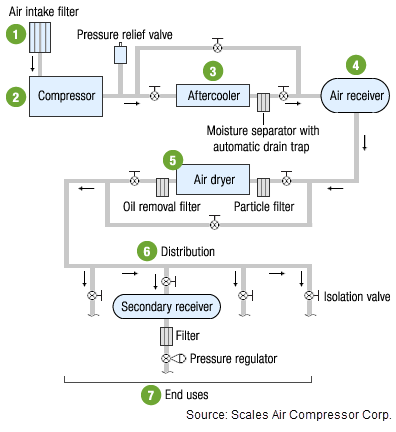

The air treatment sequence: aftercooler, moisture separator, wet receiver, pre-filter, dryer, after-filter, dry receiver, point-of-use filter. That order is not flexible.

The component most often missing is the wet receiver between the aftercooler and the dryer. Without it, the dryer takes hot saturated air carrying liquid water and tries to condense vapor out of it. It runs overloaded, performance drops, it wears out early. A wet receiver runs a few hundred dollars. A refrigerated dryer replacement runs $2,000 to $4,000, plus whatever the untreated moisture damaged downstream in the months before the dryer failure got diagnosed.

The dry receiver goes after the dryer. Stores treated air, absorbs demand spikes. Different tank, different function, different location. Most small shops have one tank in a random spot doing neither job.

Refrigerated dryers produce a dew point around 37°F. Adequate for general fabrication, pneumatic tools, packaging. Desiccant dryers go to -40°F or lower. Needed for outdoor piping in freezing climates and certain spray finishing applications. Desiccant dryers eat 15 to 18% of system air for regeneration. On a 100 CFM system that is 15 to 18 CFM vented straight to atmosphere, continuously, around the clock, as long as the dryer runs. If the application does not need -40°F dew point, that is 15% of the compressor's output thrown away to achieve a spec the application does not require.

Cycling refrigerated dryers store cold in a glycol thermal mass. The refrigeration compressor cycles off during low demand. Non-cycling designs run the refrigeration compressor nonstop with a hot gas bypass to prevent freezing. Energy gap over a year of variable load: 50 to 80%. Non-cycling dryers persist because they cost less.

A $40 to $60 differential pressure gauge on each filter housing eliminates guesswork about element life. New coalescing element: 1.5 PSI drop. Loaded element near failure: 10 or 11 PSI. Without the gauge, that extra restriction is invisible, the compressor compensates, the electricity bill climbs, and the operator thinks the compressor is losing pressure.

Oil contamination from a lubricated compressor is a more complicated problem than moisture because it exists in three phases simultaneously: liquid droplets, aerosol, and vapor. A coalescing filter handles the first two. It cannot touch vapor-phase oil. At the temperatures inside a compressed air system, a small but continuous fraction of the lubricant evaporates into the air stream and passes straight through the coalescing element as if it were not there. On the downstream side, when the air cools further in the piping, that oil vapor can re-condense onto surfaces, into products, onto paint jobs. If the application requires air that is genuinely free of oil at the point of use and the compressor is oil-injected, an activated carbon adsorber has to go after the coalescing filter to capture the vapor. The activated carbon bed has a finite capacity. It saturates. Depending on the oil loading, the carbon element may last 6 months or 18. There is no pressure drop indicator to signal when it is exhausted because vapor-phase oil does not create a pressure drop across the bed. The only way to know the carbon is spent is to test the air downstream or replace the element on a conservative schedule. Most shops that install an activated carbon filter do not test the air and do not track the element's service hours. The filter sits there, eventually saturates, and then does nothing while everyone assumes the air is clean.

Oil-free compressors avoid this entire filtration chain. That is their value proposition. Whether that value justifies the 40 to 100% price premium depends on the cost of the filtration alternative and the consequences of oil contamination in the specific application. For a body shop doing high-end refinish work where a single fish-eye in the clear coat means respraying an entire panel, the cost of one rework might exceed the annual cost difference between oil-free and oil-injected. For a tire shop running impact wrenches, the calculation is not close in the other direction.

4
Size Your Distribution System as Carefully as Your Compressor

Piping gets no budget. It gets no maintenance. After a few years it is buried under paint and insulation and nobody verifies its diameter without cutting into it.

Pressure drop in pipe increases with the square of flow velocity. A pipe running fine at 60% of capacity does not gradually struggle at 90%. It falls off a cliff. Keep main header velocity below 20 feet per second. In practice this means oversizing the pipe by one or two nominal sizes compared to what looks right based on the fittings on the compressor.

Ring main layouts allow air to reach any branch from two directions, halving velocity in each segment. Because the relationship is quadratic, halving velocity drops pressure loss by about 75%. Closing a loop during construction is cheap. Post-occupancy it is expensive enough that it almost never happens. The decision gets made during the design phase by whoever lays out the compressed air, which in a lot of new construction is a plumbing subcontractor who has never thought about ring mains and will run a trunk line from the compressor room to the farthest drop because that is how plumbing works. If no one with compressed air knowledge reviews the layout before the walls go up, the facility is locked into a dead-end distribution system for the life of the building. This happens constantly. It is one of the most consequential and most preventable mistakes in the entire compressed air chain.

20–30%

Leaks. The DOE and CAGI put the average leak rate at 20 to 30% of total compressor output across industrial facilities. A single 1/4-inch hole at 100 PSI wastes about 100 CFM, the full output of a 25 HP compressor, running around the clock including nights and weekends when the building is empty. An ultrasonic leak detector costs $1,500 to $2,500. A technician can survey a mid-sized shop in half a day. Fixes: tighten fittings, replace worn quick-disconnect couplings, swap cracked hoses, fix condensate drains stuck open. Materials cost is negligible. Payback is weeks.

Leak surveys are the single highest-return activity in compressed air management and the one that gets done least. The reason is organizational, not technical. The compressor is a capital asset with a maintenance schedule. The piping is infrastructure. It belongs to nobody. No maintenance budget covers it. No technician is assigned to it. Leaks accumulate gradually and the rising electricity cost gets attributed to rate increases or production growth. By the time someone suspects the compressed air system, the leak load has been growing for years.

Galvanized steel pipe corrodes from the inside. After a decade the rust scale narrows the bore, raises pressure drop, and sends iron oxide particles downstream. Aluminum piping (Transair is the most widely specified brand in North America, though competitors sell comparable products) resists internal corrosion and uses push-to-connect fittings that non-welders can install. Installed cost runs 25 to 35% above galvanized. Whether that matters depends on how long the business plans to be in the building. Five-year lease, galvanized is fine. Owned building with a twenty-year horizon, the internal degradation of the galvanized pipe will cost more in lost performance and contaminated air than the aluminum premium would have, and it will not be obvious that this is happening because bore reduction from corrosion is invisible without cutting the pipe open.

Point-of-use regulators: running a tool at 125 PSI when the manufacturer rates it for 90 wastes 17% of the air flowing through it. Regulators cost $30 to $50. Hose bore matters more than hose length: a 1/4-inch bore hose creates massive restriction above 15 to 20 CFM.

Condensate collects at low points in piping and has to be drained. Drip legs with automatic drains at every low point, every branch takeoff, before every point-of-use filter. Timer drains open on a fixed schedule regardless of whether liquid is present, wasting air when the leg is dry and failing to keep up during humid stretches. Zero-loss drains open only when liquid is present. They cost more per unit and waste no air. Over several years the savings across 6 to 10 drain points pays for the upgrade multiple times.

Compressor condensate from an oil-injected machine contains emulsified oil at 200 to 2,000 ppm. Discharging it to a storm drain or septic system violates the Clean Water Act. Oil-water separators built for compressor condensate reduce oil content below 10 ppm and cost $200 to $1,500. A lot of shop owners find out about this requirement from their local environmental agency rather than from their compressor dealer, which is not a pleasant conversation.

5
Plan for Reliability and Serviceability From Day One

A 50 HP air-cooled compressor at full load dumps about 126,000 BTU per hour into whatever room it occupies. One louvered vent and no exhaust fan. The temperature climbs through the shift. 100°F. 110. 120. The oil thins. Bearings run hot. The discharge temperature alarm trips and the machine shuts down. This happens on the hottest day of the year, which is also the day the shop is busiest. Or the alarm has been overridden, which happens more than manufacturers like to admit, and the airend seizes at 250°F discharge temperature. A ventilation problem that could have been fixed with a $200 exhaust fan and a $50 wall louver turns into a $12,000 airend rebuild. Every compressor manual specifies the required room ventilation in CFM. At a lot of installations it has never been read, and the compressor room was chosen because it was the only space available, not because it was suitable.

Airend failures follow a pattern that repeats across manufacturers, across decades of service records. Lubricant runs past its service life. Viscosity drops. Varnish deposits form on rotor surfaces and inside the oil circuit. The bearing surfaces that should be separated by a hydrodynamic film start touching. Once bearing degradation begins, the failure accelerates. If the bearing comes apart inside the airend, the rotors contact the housing bore and the airend is scrap. Chronic elevated discharge temperature from blocked cooler fins or bad ventilation feeds this by oxidizing the oil and hardening seals. Old oil runs hotter. Hot oil ages faster. The two causes reinforce each other until something breaks.

A separate failure mechanism works on a different timeline. When a rotary screw compressor starts, runs for 8 minutes, shuts down, starts again, runs for 6 minutes, shuts down, and repeats this all day, the airend may never reach the discharge temperature needed to boil moisture out of the sump. Each short cycle adds water to the oil. Over weeks the oil becomes an emulsion that corrodes internal surfaces and destroys the lubrication film the bearings depend on. Minimum run time per start is 20 to 30 minutes. Machines controlled by simple pressure switches that start and stop the motor in rapid succession are the most vulnerable to this. The damage is invisible until the airend seizes and the service tech drains the sump and finds milky fluid instead of oil.

Preventing all of this requires four things and none of them are complicated: oil changes on schedule, clean cooler fins, adequate ventilation, control logic that prevents short-cycling.

Since the machine dumps 126,000 BTU per hour into the room regardless, ducting that exhaust air to a space that needs heating in winter is one of the few ways to claw back some of the 90% energy loss. A thermostatically controlled damper on the exhaust routes hot air into the shop during cold months and outside during warm months. The installation is a weekend project for anyone comfortable with sheet metal ductwork. It will not transform the energy economics of the system but it is free heating from waste energy, and in a northern climate it adds up over the winter.

Controller technology affects both reliability and efficiency. Basic load/unload controls use a pressure band: the machine loads when pressure drops to one set point and unloads when it rises to another. A narrow band (5 PSI) causes frequent cycling. A wide band (15 PSI) reduces cycling but delivers inconsistent pressure. More sophisticated controllers learn demand patterns and anticipate load changes. Some manufacturers include them; others sell them as options for $1,000 to $3,000. A controller that eliminates 10 unnecessary load/unload cycles per hour across a year saves more energy than it costs, and it also reduces the moisture-in-sump problem described above because fewer cycles means fewer thermal excursions.

Parts supply chain determines how long a breakdown lasts. Call the local dealer's parts counter and ask what is physically on the shelf. Not the salesperson. The parts counter. Oil filters, air filters, separator elements, inlet valve kits. If any of those is a special-order item with a multi-week lead time, the facility is one service interval away from either downtime or a rental compressor at $400 to $600 per day.

If compressed air downtime halts production, one compressor is one point of failure. Two machines each sized for the base load, with a sequencing controller to alternate lead and lag, provide backup. Capital doubles. For a two-person welding shop the answer might favor a single machine with a good service contract. For a packaging line running 16 hours a day with 30 employees standing around when the air goes down, it is a different calculation.
